Architect's Site Supervision Checklist
Construction

Architect's Site Supervision Checklist

Stage-by-Stage Quality Checks for Indian Residential Construction

26 min readAmogh N P17 April 2026

A building is only as good as the care taken during its construction. The most elegant design, the most sophisticated structural calculation, the most expensive materials — all are rendered meaningless if the execution on site is careless, uninformed, or unsupervised. In India, where an average of seven people die every day from structural collapses — with 73% of these involving residential buildings — the stakes of construction quality are measured not in rupees, but in lives (NCRB, 2021).

Yet the reality of Indian residential construction remains sobering. The overwhelming majority of homes — particularly in Tier-2 and Tier-3 cities, and almost universally in rural India — are built without any formal architectural or engineering supervision. Construction is left entirely to contractors and masons, many of whom work from experience and intuition rather than drawings and codes. The results are predictable: rework costs consuming 3–6% of project value, waterproofing failures appearing within months of occupation, reinforcement corrosion beginning within years, and in the worst cases, partial or complete structural failure.

This guide provides a stage-by-stage supervision checklist for Indian residential construction, grounded in Bureau of Indian Standards (BIS) codes and professional best practice. It is written for architects, structural engineers, project managers, and informed homeowners who understand that quality is not inspected into a building after the fact — it is built into it, one supervised pour, one checked rebar cage, one verified waterproofing membrane at a time.

"God is in the details." — Ludwig Mies van der Rohe, German-American architect and pioneer of modernism


1. The Case for Supervision: Why It Matters

The Architects (Professional Conduct) Regulations, 1989, issued under the Architects Act, 1972, are unambiguous: an architect must exercise "a reasonable degree of knowledge and skill" and "a reasonable degree of care" in the discharge of professional duties. Failure to provide services necessary for discharge of duties constitutes "deficient service" and amounts to professional misconduct under Section 30 of the Architects Act (Council of Architecture, 1989).

The Real Estate (Regulation and Development) Act, 2016 (RERA) has added a powerful enforcement mechanism. Section 14(3) mandates a five-year defect liability period from the date of possession, during which the developer must rectify structural defects, workmanship issues, and material defects at no cost to the buyer. As of 2025, over 1.38 lakh complaints have been resolved through RERA, and RERA 2.0 has introduced higher fines, digital monitoring, and surprise inspections (Government of India, 2016).

For the architect, supervision is not an optional service — it is a professional and legal obligation. For the homeowner, insisting on supervision is not a luxury — it is the single most effective quality assurance mechanism available.

The Cost of Not Supervising

MetricStatisticSource
Average rework cost3–6% of project valueIyer and Jha, 2021
Annual deaths from building collapses in India~2,658 (avg. 7 per day)NCRB data, 2021
Residential buildings as % of collapse incidents73%NCRB data, 2021
RERA defect liability period5 years from possessionRERA Section 14(3)
Top cause of reworkUntrained workers at siteKumar et al., 2023

"The physician can bury his mistakes, but the architect can only advise his clients to plant vines." — Frank Lloyd Wright, American architect


2. The Complete Stage-by-Stage Supervision Checklist

Stage 1: Site Clearing and Layout

The foundation of quality construction is an accurate layout. Before any excavation begins, the architect must verify that the site layout — setbacks, building footprint, column positions, and ground levels — matches the approved building plan precisely.

Critical Checks:

  • Boundary verification against survey records
  • Setback dimensions (front, rear, sides) per approved plan and local development control rules
  • Column centre marking using theodolite or total station (not tape alone for buildings >G+1)
  • Ground level benchmarks established and recorded
  • Natural drainage patterns identified and protected
  • Soil type visually assessed against geotechnical report

Common Defects: Wrong setbacks (leading to municipal violation), layout errors compounding through all subsequent stages, ignoring natural drainage.

Acceptance Criteria: Layout matches approved plan within +/- 25 mm. Setbacks verified against municipal approval drawing.


Stage 2: Excavation

Critical Checks:

  • Excavation depth matches structural drawing and geotechnical recommendation
  • Soil at formation level matches the bearing capacity assumed in structural design (visual and SPT correlation)
  • Side slopes stable and shored where necessary
  • Dewatering in place if water table encountered
  • No loose soil or debris at formation level before PCC

IS Code Reference: IS 1904:1986 (Foundation design); IS 1892:1979 (Soil investigation)

Common Defects: Under-excavation (insufficient depth), waterlogged trenches poured without dewatering, no soil test conducted.


Stage 3: PCC and Foundation

The foundation pour is the most critical irreversible milestone. Once concrete is placed, corrections are virtually impossible without demolition. The architect's presence — or that of a delegated structural engineer — during the pre-pour rebar check is non-negotiable.

Critical Checks — PCC (Plain Cement Concrete):

  • Mix ratio as specified (typically 1:4:8 or M7.5)
  • Minimum thickness 100 mm (or as specified)
  • Surface levelled and compacted
  • Curing commenced within 24 hours

Critical Checks — Footing Reinforcement:

  • Rebar diameter and spacing per bar bending schedule (BBS)
  • Cover blocks in place: minimum 50 mm for footings (IS 456:2000, Table 16)
  • Cover blocks made of concrete (not stone chips or broken bricks)
  • Lap lengths per IS 456 Clause 26.2.5 (minimum 50 x bar diameter for compression; calculated value for tension)
  • Stirrup hooks closed at 135 degrees (not 90 degrees)
  • Column starter bars positioned correctly and extending to required height
  • Formwork rigid, clean, and oiled

Critical Checks — Footing Concrete:

  • Concrete grade as specified (minimum M20 for RCC per IS 456)
  • Slump test conducted on site (25–75 mm for footings)
  • Cube samples taken per IS 456 frequency requirements
  • Needle vibrator used for compaction (not manual rodding)
  • No interruption during pour (to prevent cold joints)

Concrete Cube Testing Requirements (IS 456:2000, Clause 15.2.2)

Quantity of Concrete (m3)Minimum SamplesCubes per Sample7-Day Test28-Day Acceptance Criteria
1–513~67% of 28-day target (indicative only)Individual >= fck - 3 N/mm2; Mean of 4 consecutive >= fck + 0.825 x SD
6–1523 eachSameSame
16–3033 eachSameSame
31–5043 eachSameSame
51+4 + 1 per additional 50 m33 eachSameSame

Source: IS 456:2000, Clause 15.2.2. For M20 concrete (fck = 20 N/mm2): individual cube result must be >= 17 N/mm2; mean of 4 non-overlapping consecutive results >= 23 N/mm2 (assuming standard deviation ~4 N/mm2).

"Quality is never an accident. It is always the result of intelligent effort." — John Ruskin, British art critic and architectural theorist


Stage 4: Plinth Beam and DPC

Critical Checks — Plinth Beam:

  • Rebar continuity through corners (L-bars, not straight-cut)
  • Stirrup spacing per structural drawing (typically 150 mm c/c near supports, 200 mm c/c at midspan)
  • Stirrups closed with 135-degree hooks
  • Concrete cover: 25–30 mm (moderate exposure)
  • No cold joints — entire beam poured in single operation where possible

Critical Checks — Plinth Fill and DPC:

  • Fill material: clean earth, murrum, or sand (no construction debris)
  • Compaction in layers of maximum 200 mm
  • Damp Proof Course (DPC) material applied continuously — no breaks or gaps
  • DPC not bridged by external plaster (a common and critical error)

IS Code Reference: IS 456:2000 (Concrete); IS 3067:1988 (DPC); IS 2212:1991 (Brickwork below plinth)


Stage 5: Superstructure — Columns

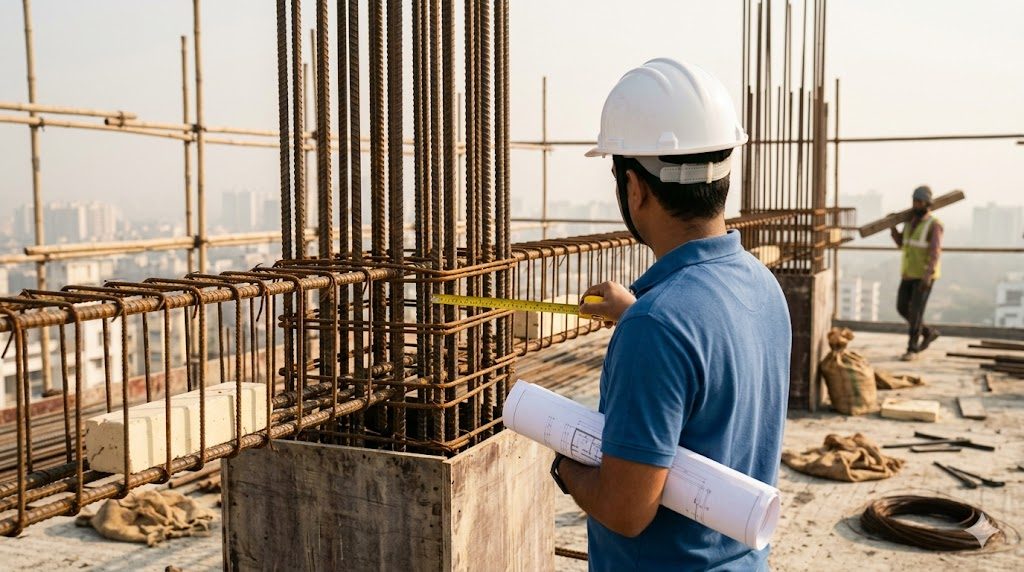

Critical Checks:

  • Column vertical alignment (plumb): within 1:500 (2 mm per metre)
  • Rebar count, diameter, and arrangement per structural drawing
  • Tie/stirrup spacing: critically important at beam-column joints — IS 13920:2016 requires close spacing in potential plastic hinge zones
  • Concrete cover: minimum 40 mm for columns (IS 456:2000, Table 16)
  • Formwork rigid and properly braced — no bulging under concrete pressure
  • Kicker (50–75 mm concrete at column base) to prevent grout loss

Common Defects: Column out of plumb, ties missing or widely spaced at beam-column joints, honeycombing from inadequate vibration, insufficient cover.

Minimum Concrete Cover Requirements (IS 456:2000)

Structural ElementNominal Cover (mm)Exposure ConditionKey Note
Footing50All conditionsIn contact with soil; most critical
Column40Moderate to severeReduce to 25 mm only if dimension <= 200 mm and bars <= 12 mm
Beam25–30Moderate30 mm for moderate exposure; 45 mm for severe
Slab20–25Mild to moderate20 mm for mild; 25–30 mm for moderate
Staircase25ModerateSimilar to slab requirements
Retaining wall45–50Severe to very severeIn contact with soil and moisture

Source: IS 456:2000, Table 16 and Clause 26.4. Tolerance: actual cover shall not deviate from nominal cover by more than +10 mm.


Stage 6: Superstructure — Beams and Slabs

Critical Checks — Beams:

  • Bottom bars and top bars: count and diameter per drawing
  • Cranked (bent-up) bars at correct position (L/7 from support face)
  • Stirrup spacing: closer near supports (typically 100–150 mm), wider at midspan (typically 200 mm)
  • Beam-column joint: adequate confinement reinforcement
  • Formwork adequately propped — deflection must not exceed span/250

Critical Checks — Slabs:

  • Slab thickness verified: +/- 5 mm tolerance
  • Main reinforcement and distribution steel: bar diameter and spacing per drawing in both directions
  • Cover: 20–25 mm (cover blocks at maximum 1 m spacing)
  • Openings for MEP (plumbing risers, AC piping, electrical) pre-planned — no cutting of rebar after pour
  • Construction joint location pre-determined if slab area is large
  • Chairs/spacers for top reinforcement in two-way slabs

Critical Checks — Concreting (Beams and Slabs):

  • Pour sequence: columns first (previous day), then beams and slab together
  • Concrete grade and slump verified on arrival (50–100 mm for slabs)
  • Cube samples collected per IS 456 frequency
  • Vibration: needle vibrator for beams, surface vibrator for slabs
  • Curing commenced within 12 hours: minimum 7 days for OPC, 10 days for blended cement, 14 days in hot/dry conditions (IS 456, Clause 13.5)

Common Defects: Bars displaced during pouring, inadequate cover in slabs, formwork deflection causing uneven slab soffit, premature stripping of formwork.

Water-Cement Ratio and Minimum Cement Content (IS 456:2000, Table 5)

Exposure ConditionMinimum Concrete Grade (RCC)Maximum W/C RatioMinimum Cement Content (kg/m3)
MildM200.55300
ModerateM250.50300
SevereM300.45320
Very SevereM350.45340
ExtremeM400.40360

Source: IS 456:2000, Table 5. Most residential construction in urban India falls under 'moderate' exposure — requiring minimum M25 concrete with W/C ratio not exceeding 0.50.

"As an architect, you are a builder. You are of course more than a builder. You need to be a militant, you need to be a poet, you need to be a visionary, you need to be an artist. But certainly you have to be a builder. Everything starts from there." — Renzo Piano, Italian architect, Pritzker Prize laureate


Stage 7: Brickwork and Masonry

Critical Checks:

  • Brick quality: minimum Class 75 for load-bearing, Class 50 for non-load-bearing (IS 1077)
  • Bricks soaked in water for minimum 2 hours before laying (dry bricks absorb moisture from mortar, weakening the bond)
  • Mortar mix as specified (typically 1:6 cement-sand for non-load-bearing; 1:4 for load-bearing)
  • Wall plumb: deviation not exceeding 5 mm per 3 m height
  • Mortar joint thickness: 10 mm (+/- 3 mm) — thick joints are a sign of poor workmanship
  • Bond pattern: English bond or Flemish bond for structural walls; stretcher bond only for half-brick partitions
  • Lintels provided above every opening (door, window, ventilator)
  • Seismic bands at plinth, lintel, and roof levels in Zones III–V (IS 4326:2013)
  • Tooth-joint (toothing) or wire mesh at RCC column-to-brick wall junction (to prevent separation cracks)
  • Curing: minimum 7 days of water curing

IS Code Reference: IS 2212:1991 (Brickwork); IS 1905:1987 (Structural masonry); IS 4326:2013 (Seismic provisions)

Common Defects: Walls out of plumb, dry bricks (no soaking), thick mortar joints (>15 mm), no lintels above small openings, no curing, no seismic bands.


Stage 8: MEP Rough-in — Plumbing and Electrical

This is the last opportunity to verify concealed services before they are buried under plaster and tiles. Errors discovered after concealment require destructive investigation and expensive rework.

Critical Checks — Plumbing:

  • Waste pipe slopes: minimum 1:40 (25 mm fall per metre) for 75–100 mm pipes
  • Supply pipes: pressure tested at 1.5 times working pressure for 24 hours with no drop
  • Vent pipes: connected and extended above terrace level
  • Floor traps: installed at correct invert levels with adequate trap depth (minimum 50 mm water seal)
  • No reduction in pipe diameter in the direction of flow
  • Pipe supports at specified intervals — no sagging

Critical Checks — Electrical:

  • Conduit routing: no sharp bends (minimum radius = 4 x conduit diameter)
  • Conduit size adequate for number of wires (IS 732:1989)
  • Circuit loading calculated: lighting, power, and heavy-duty (AC, geyser) on separate circuits
  • Distribution board (DB) placement at accessible height (1.5 m from floor)
  • Earthing: dedicated earth wire in every circuit; earthing pit installed per IS 3043
  • Junction boxes accessible (not concealed behind false ceiling without access panel)

IS Code Reference: IS 2065:1983 (Water supply); IS 12828 (Plumbing installation); IS 732:1989 (Electrical wiring); IS 3043 (Earthing)

Acceptance Criteria: Plumbing pressure test passed (no leak for 24 hours); electrical insulation resistance > 1 megaohm; earthing resistance < 1 ohm.


Stage 9: Plastering

Critical Checks:

  • Wall surface preparation: clean, wetted, raked joints for key
  • Chicken mesh (galvanised wire mesh) at RCC-to-brick junctions — this prevents the crack that invariably forms at the interface of two different materials
  • Mix ratio: 1:4 (cement:sand) for external walls; 1:6 for internal walls (or as specified)
  • Thickness: 12–15 mm for internal, 15–20 mm for external — applied in two coats if > 12 mm
  • Plumb and line: checked with 2 m straight edge — deviation not exceeding 3 mm
  • Curing: minimum 7 days of continuous water curing (the single most common failure in Indian plastering is the absence of curing)

IS Code Reference: IS 1661:1972 (Cement and cement-lime plaster)

Common Defects: Map cracking from no curing, debonding at RCC-brick junction (no chicken mesh), uneven thickness, hollow areas from poor bonding.

"Is it necessary? If it is not necessary, do not do it!" — Laurie Baker, British-Indian architect, known as the 'Gandhi of Architecture'


Stage 10: Waterproofing

Waterproofing failures are the single most common post-occupancy complaint in Indian residential construction. They are also among the most preventable — if the work is supervised and tested.

Critical Checks — Bathrooms and Toilets:

  • Waterproofing membrane (polymer-modified cementitious coating, APP membrane, or liquid-applied) applied to entire floor and walls up to minimum 150 mm above finished floor level (coving)
  • Membrane continuity at pipe penetrations — sealed with compatible sealant
  • Membrane overlaps at joints: minimum 100 mm

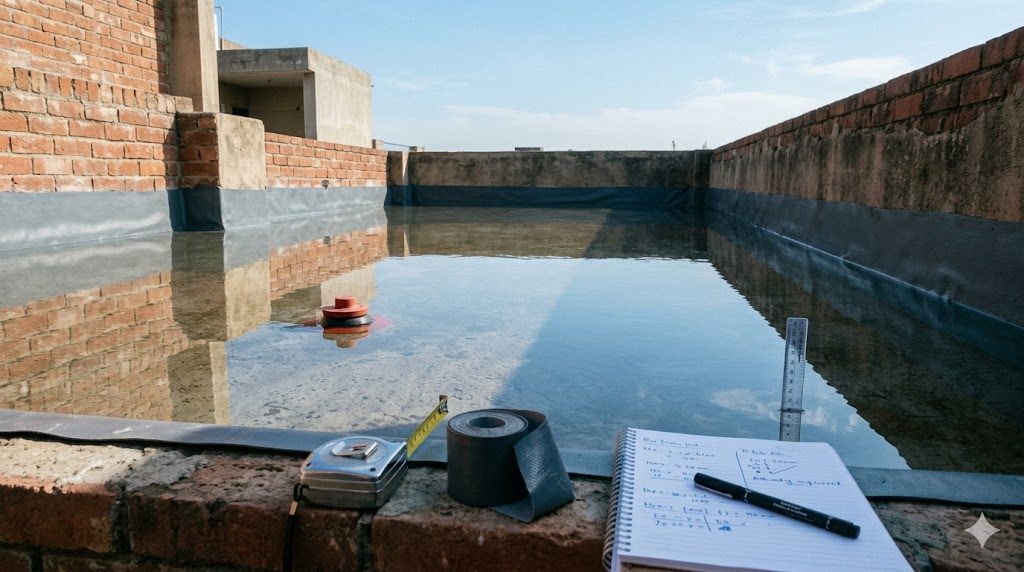

  • 48-hour flood test conducted before tiling: floor flooded to 50 mm depth, ceiling below inspected for any signs of dampness or drip
  • Screed over membrane: minimum 20 mm, sloped toward floor drain (minimum 1:80)

Critical Checks — Terrace/Roof:

  • Membrane applied over entire terrace area including parapet upstands (minimum 300 mm up parapet)
  • Slope toward rainwater outlets: minimum 1:120
  • Membrane protected with screed before any further work
  • 48-hour flood test before screed/tiling
  • Expansion joints provided in terrace screed at maximum 3 m intervals

IS Code Reference: IS 3067:1988 (Waterproofing)

Common Defects: Membrane punctured by tiling contractor, insufficient coving height, no flood test conducted, membrane not taken up parapet, cracks at pipe penetrations.


Stage 11: Flooring and Tiling

Critical Checks:

  • Substrate level and flat — checked with 2 m straight edge
  • Bathroom floor slope toward drain: verified with water test before tiling
  • Tile adhesive: full-bed application for floor tiles (not five-spot method which creates voids)
  • Tap test after 24 hours: every tile tapped with knuckle — hollow sound indicates debonded tile
  • Grout: uniform width and colour; epoxy grout recommended for wet areas
  • Anti-skid tiles in wet areas (bathrooms, balconies, external passages)
  • Skirting and edge tiles aligned and level

IS Code Reference: IS 13006 (Ceramic tiles)

Common Defects: Hollow tiles (lippage), wrong slopes in bathrooms (water pooling), uneven grout lines, non-anti-skid tiles in wet areas.


Stage 12: Joinery, Painting, and Finishing

Critical Checks — Doors and Windows:

  • Frame plumb and level: deviation not exceeding 2 mm
  • Hardware (hinges, locks, handles) functional — cycles tested
  • Weather sealing at external window frames: continuous sealant bead
  • Glass thickness per specification; safety glass where required (IS 2553)

Critical Checks — Painting:

  • Surface preparation: putty applied, sanded, and primed before paint
  • Minimum 2 coats of paint over 1 coat of primer
  • Colour consistency: no variation between walls or patches
  • External paint: weather-resistant grade applied

IS Code Reference: IS 1948 (Aluminium doors/windows); IS 4021 (Timber doors); IS 2395 (Painting)


Stage 13: Pre-Handover Snag Walk and Handover

The final act of supervision is the most meticulous. A comprehensive snag walk — room by room, surface by surface, fitting by fitting — generates a punch list that must be fully resolved before handover.

Snag List Categories:

  • Structural: Visible cracks in beams, columns, or slabs (any crack > 0.3 mm warrants investigation per IS 456)
  • Waterproofing: Any sign of dampness on ceilings, walls, or around pipe penetrations
  • Plumbing: Every tap, flush, and drain tested for function, flow, and leakage
  • Electrical: Every switch, socket, light point, and fan point tested; MCB/RCCB trip tested
  • Finishing: Paint touch-ups, grout repairs, hardware adjustments, sealant gaps
  • External: Drainage slope (no ponding after simulated rainfall), compound wall, gate hardware

Documentation Handover:

  • Approved building plan and structural drawings
  • As-built drawings (reflecting any changes during construction)
  • Structural design report signed by structural engineer
  • Cube test reports (7-day and 28-day)
  • Waterproofing test certificates
  • Electrical test certificates (insulation resistance, earthing)
  • Plumbing pressure test certificates
  • Material warranties and product data sheets
  • Completion/occupancy certificate from local authority
  • RERA registration details (if applicable)


3. Recommended Site Visit Frequency

For a typical G+2 residential project spanning 12–18 months, the following visit schedule represents professional best practice:

Construction StageRecommended Visit FrequencyPriority LevelNotes
Site clearing and layout1–2 visitsHighVerify layout matches approved plan
Excavation1 visit at final depthHighVerify depth and soil condition
Foundation reinforcement1 visit before each pour (mandatory)CriticalLast chance to check rebar and cover
Foundation concretingPresent during pour or delegateCriticalMonitor compaction and cube sampling
Plinth beam and DPC1 visitHighVerify fill compaction and DPC continuity
Column and beam rebar1 visit per floor before pour (mandatory)CriticalMost critical structural check
Slab rebar1 visit per slab before pour (mandatory)CriticalCheck bar spacing, cover, openings
Slab concretingPresent or delegate for each pourCriticalMonitor compaction and curing plan
Brickwork1–2 visits per floorMediumCheck plumb, mortar, lintel placement
MEP rough-in1–2 visitsHighVerify before concealment
Plastering1 visit per floorMediumCheck thickness, chicken mesh, surface
Waterproofing1 visit + flood test verificationCriticalMust witness or verify flood test results
Tiling and flooring1–2 visitsMediumCheck level, slopes, adhesion
Finishing and painting1–2 visitsMediumSurface prep, colour approval
Pre-handover snag walk1 comprehensive walk-throughCriticalGenerate and close snag list
Formal handover1 visitHighDocumentation and keys

Total for a typical G+2 residential project: approximately 25–35 site visits over 12–18 months.

The cost of this supervision — typically 1–3% of construction cost — is negligible compared to the 3–6% rework cost incurred when supervision is absent, and infinitely small compared to the cost of structural failure.


4. The Ten Most Common Construction Defects in Indian Homes

RankDefectRoot CauseConsequencePrevention
1Honeycombing in columns and beamsPoor vibration, congested rebar, low slumpReduced load capacity, water ingress, corrosionProper needle vibrator; check rebar congestion before pour
2Insufficient concrete coverNo cover blocks, rebar displaced during pourReinforcement corrosion within 5–10 years, spallingCorrect cover blocks tied securely; verify before pour
3Cold joints in concreteDelayed pouring, interruption mid-pourWeak shear plane, water leakage through jointPlan pour schedule; use retarders if delays anticipated
4Bathroom leakage to floor belowNo waterproofing membrane, cracked screedCeiling damage, mould growth, structural dampnessMembrane before tiling; 48-hr flood test mandatory
5Terrace leakageMembrane punctured, insufficient slopeCeiling stains, long-term structural damageProtect membrane; verify slope before screed
6Plaster cracking at RCC-brick junctionNo chicken mesh at interfaceAesthetic failure, water ingressGalvanised wire mesh at all RCC-brick junctions
7Cracks in brick wallsNo curing, no lintels, differential settlementWater ingress, aesthetic damageCure 7 days; lintels above all openings
8Hollow floor tilesFive-spot adhesive instead of full-bedTiles crack under load, trip hazardFull-bed adhesive; tap test after 24 hours
9Overloaded electrical circuitsNo circuit calculation, undersized cablesFire hazard, MCB nuisance trippingCalculate loads per circuit; proper cable sizing
10Blocked drains after handoverConstruction debris left in pipesFlooding, sewage backupCap all open pipes; pressure test before concealment

"A good building does not hurt the landscape but makes the landscape more beautiful than it was before the building was built." — Laurie Baker, British-Indian architect (Baker, 1986)


5. The Architect's Professional Duty

The Council of Architecture (CoA) and the Architects Act, 1972 define the architect's supervisory obligations with clarity. An architect is professionally bound to ensure that construction proceeds in accordance with the approved design and applicable codes. The CoA Professional Conduct Regulations specify that an architect shall not be held liable when: (a) the building is used for purposes other than designed; (b) changes are made without the architect's consent; or (c) damage results from non-compliance with the architect's instructions (Council of Architecture, 1989).

These exemptions, however, are conditional on the architect having actually exercised supervision. An architect who signs off on a building without conducting site inspections has no defence against claims of professional negligence. Under RERA, the five-year defect liability provision means that quality failures discovered years after handover can result in mandatory rectification orders and financial penalties against the developer — costs that are ultimately traceable to inadequate supervision during construction (Government of India, 2016).

"The construction detail is as important as the general idea: without correct materialisation, the design loses its strength." — Renzo Piano, Italian architect, Pritzker Prize laureate


6. A Note on Site Documentation

Every site visit should produce a written record. A site inspection report — even a simple one-page format — serves three purposes: it documents the quality status at each stage, it creates a contractual record of instructions given to the contractor, and it provides an audit trail in the event of any dispute.

The report should include:

  • Date, time, and weather conditions
  • Construction stage at time of visit
  • Observations — compliant and non-compliant
  • Photographs with annotations
  • Instructions to contractor (with acknowledgement signature)
  • Cube test sample reference numbers
  • Next scheduled visit and expected stage

In the age of smartphones, there is no excuse for undocumented site visits. Photograph every rebar cage before the pour. Photograph every waterproofing membrane before the screed. Photograph every electrical rough-in before the plaster. These photographs are both a quality record and a professional safeguard.


References

  • Arora, S.P. and Bindra, S.P. (2017) A Textbook of Building Construction. 11th edn. New Delhi: Dhanpat Rai Publications.
  • Baker, L. (1986) Mud: Toward an Architecture in India. Laurie Baker Archive, Thiruvananthapuram.
  • Bureau of Indian Standards (1972) IS 1661:1972 — Code of Practice for Application of Cement and Cement-Lime Plaster Finishes. New Delhi: BIS.
  • Bureau of Indian Standards (1983) IS 2065:1983 — Code of Practice for Water Supply in Buildings. 2nd rev. New Delhi: BIS.
  • Bureau of Indian Standards (1988) IS 3067:1988 — Code of Practice for General Design Details and Preparatory Work for Damp-proofing and Water-proofing of Buildings. 2nd rev. New Delhi: BIS.
  • Bureau of Indian Standards (1989) IS 732:1989 — Code of Practice for Electrical Wiring Installations. 3rd rev. New Delhi: BIS.
  • Bureau of Indian Standards (1991) IS 2212:1991 — Code of Practice for Brickworks. 1st rev. New Delhi: BIS.
  • Bureau of Indian Standards (1999) IS 14687:1999 — Guidelines for Falsework for Concrete Structures. Reaffirmed 2005. New Delhi: BIS.
  • Bureau of Indian Standards (2000) IS 456:2000 — Plain and Reinforced Concrete — Code of Practice. 4th rev. New Delhi: BIS.
  • Bureau of Indian Standards (2008) IS 1786:2008 — High Strength Deformed Steel Bars and Wires for Concrete Reinforcement — Specification. 4th rev. New Delhi: BIS.
  • Bureau of Indian Standards (2013) IS 4326:2013 — Earthquake Resistant Design and Construction of Buildings — Code of Practice. 3rd rev. New Delhi: BIS.
  • Bureau of Indian Standards (2016) National Building Code of India 2016. SP 7:2016. New Delhi: BIS.
  • Council of Architecture (1989) Architects (Professional Conduct) Regulations, 1989. New Delhi: CoA.
  • Government of India (1972) The Architects Act, 1972 (Act No. 20 of 1972). New Delhi.
  • Government of India (2016) Real Estate (Regulation and Development) Act, 2016. New Delhi.
  • Iyer, K.C. and Jha, K.N. (2021) 'Causal model for rework in building construction for developing countries', Journal of Construction Engineering and Management, ASCE.
  • Kumar, R. et al. (2023) 'Analysis of factors causing rework and their mitigation strategies in construction projects', Materials Today: Proceedings.
  • Kumar, S. (2023) Building Construction. 20th edn. New Delhi: Dhanpat Rai & Co.
  • Mahadik, S., Kambekar, A. and Naik, T. (2023) 'Factors influencing defects in residential buildings', Journal of Building Pathology and Rehabilitation, 8(2).
  • Rangwala, S.C. (2022) Engineering Materials. Revised edn. Ahmedabad: Charotar Publishing House.
  • Shetty, M.S. (2005) Concrete Technology: Theory and Practice. Revised edn. New Delhi: S. Chand & Company.

Author's Note: This guide draws on published BIS codes, peer-reviewed research, and professional best practice in Indian residential construction. All IS code references cite the latest revisions known at the time of writing — readers should verify current editions via the BIS website (bis.gov.in). Site supervision is a professional service that must be conducted by qualified architects and engineers; this guide is intended to inform and supplement, not to substitute for professional judgement. All acceptance criteria cited are from applicable IS codes and represent minimum standards — project-specific requirements may be more stringent.

Disclaimer: This article is for informational and educational purposes only. It does not constitute professional engineering or architectural advice. Construction supervision must be conducted by qualified professionals in accordance with applicable IS codes, local building bye-laws, and professional regulations.

Export this guide
